GLOBALTEK ENGINEERING KNOWLEDGE HUB · ACTIVITY 01

Interiors & Fit-out Works

Interior execution is a coordination problem before it is a finishes problem. Geometry, interfaces, access, tolerances, fire/acoustic continuity and the sequence of concealed work determine whether the visible finish can be delivered cleanly.

22 technical visuals6 execution stages9 technical chaptersQA/QC + failures + maintenance
Interiors & Fit-out Works technical hero
GUIDE MAP

Read the discipline visually, then go into the engineering detail.

Every image below is activity-specific. No repeated generic placeholder sheets are used in this guide.

01 · SYSTEM OVERVIEW

What this activity is

Interiors & Fit-out Works overview drawing

What this activity is

Interior fit-out is the construction and finishing of the inside of a building after the base structure exists. It can include demolition, partitions, ceilings, flooring, painting, joinery, electrical and plumbing modifications, HVAC distribution, fire-life-safety interfaces, signage and final fixtures. The quality of fit-out depends heavily on coordination: an attractive ceiling is still a failed installation if access panels, sprinkler heads, diffusers and lighting are poorly aligned or cannot be maintained.

What to expect

A client should expect a controlled sequence rather than a collection of isolated trades. The process starts with defining the brief, surveying the site, confirming landlord and authority constraints, freezing coordinated drawings and samples, and then executing in layers so concealed work can be inspected before it is covered. A good fit-out team protects finished work, manages interfaces between trades and hands over with records rather than simply “finishing the room.”

01Freeze room data and performance requirements before procurement
02Survey existing structure and services against coordinated drawings
03Resolve ceiling, partition, joinery and MEP interfaces before closure
04Use mock-ups for high-visibility junctions and repetitive details
05Protect completed work from following trades
06Handover includes test records, as-builts, warranties and maintainable access
02 · ENGINEERING FUNDAMENTALS

Understand why the system behaves the way it does.

01

Setting-out closure check: design dimension = verified site dimension + agreed construction tolerance allowance

02

Wet-area fall (%) = vertical drop / horizontal run × 100; actual values follow the approved waterproofing and drainage design

03

Ceiling coordination zone = soffit-to-finish depth − structure/fixings − required service clearances

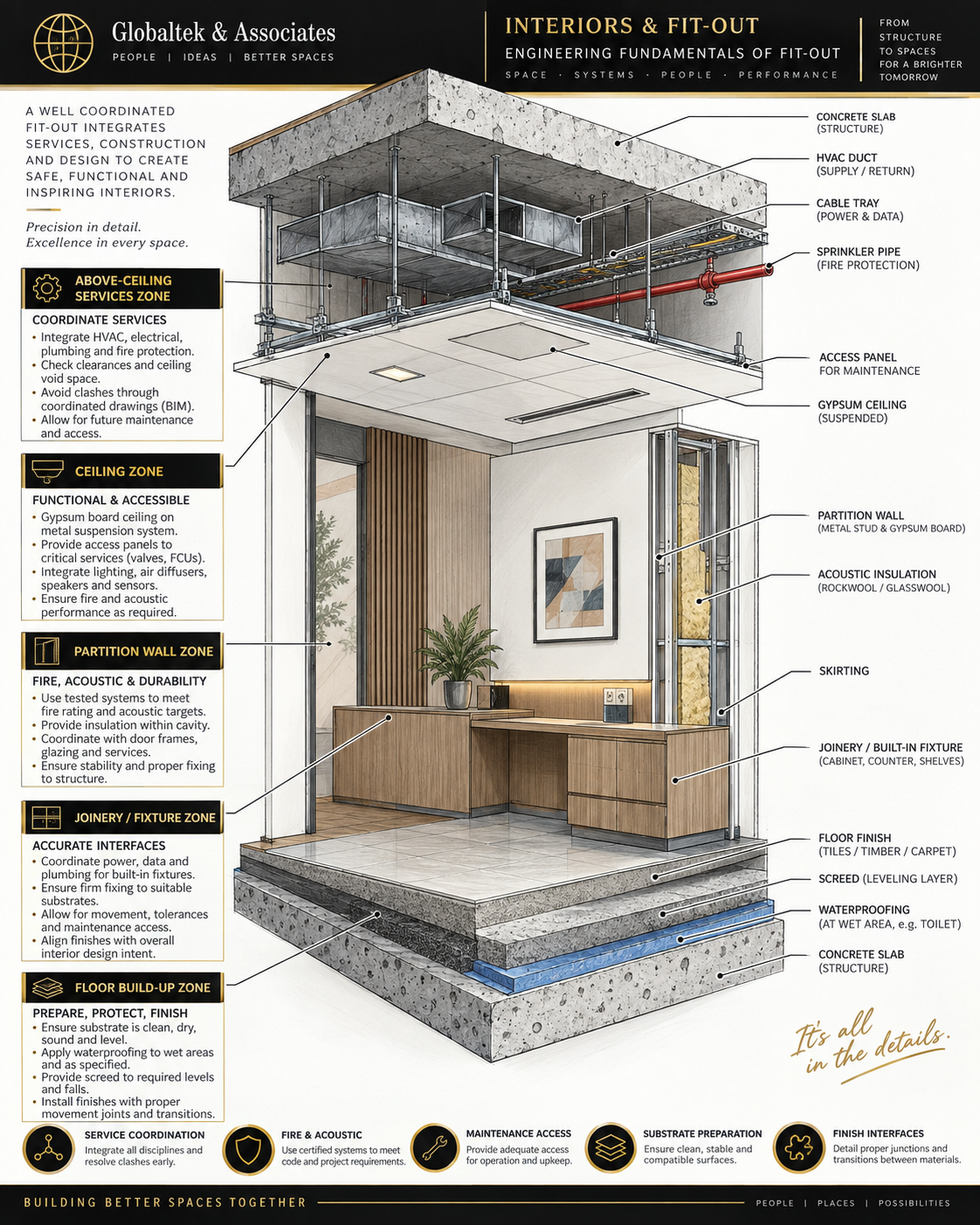

Interiors & Fit-out Works engineering fundamentals
01

A fit-out package fails most often at interfaces: door frames against partitions, stone against joinery, access panels against MEP equipment, and ceiling features around sprinklers/diffusers. Detail these junctions before fabrication.

02

Tolerance accumulation matters. Small deviations in blockwork, plaster, floor level, framing and joinery can add together; critical feature lines should be controlled from common survey datums rather than from adjacent finished elements.

03

Aesthetic mock-ups are also technical tests. Use them to prove substrate preparation, junction geometry, colour/texture, lighting interaction, access and the sequence for repeatable workmanship.

03 · EXECUTION WORKFLOW

Six progressive stages from preparation to verified handover.

Open any plate to read the full-resolution technical notes.

Design Freeze technical drawing
STAGE 01

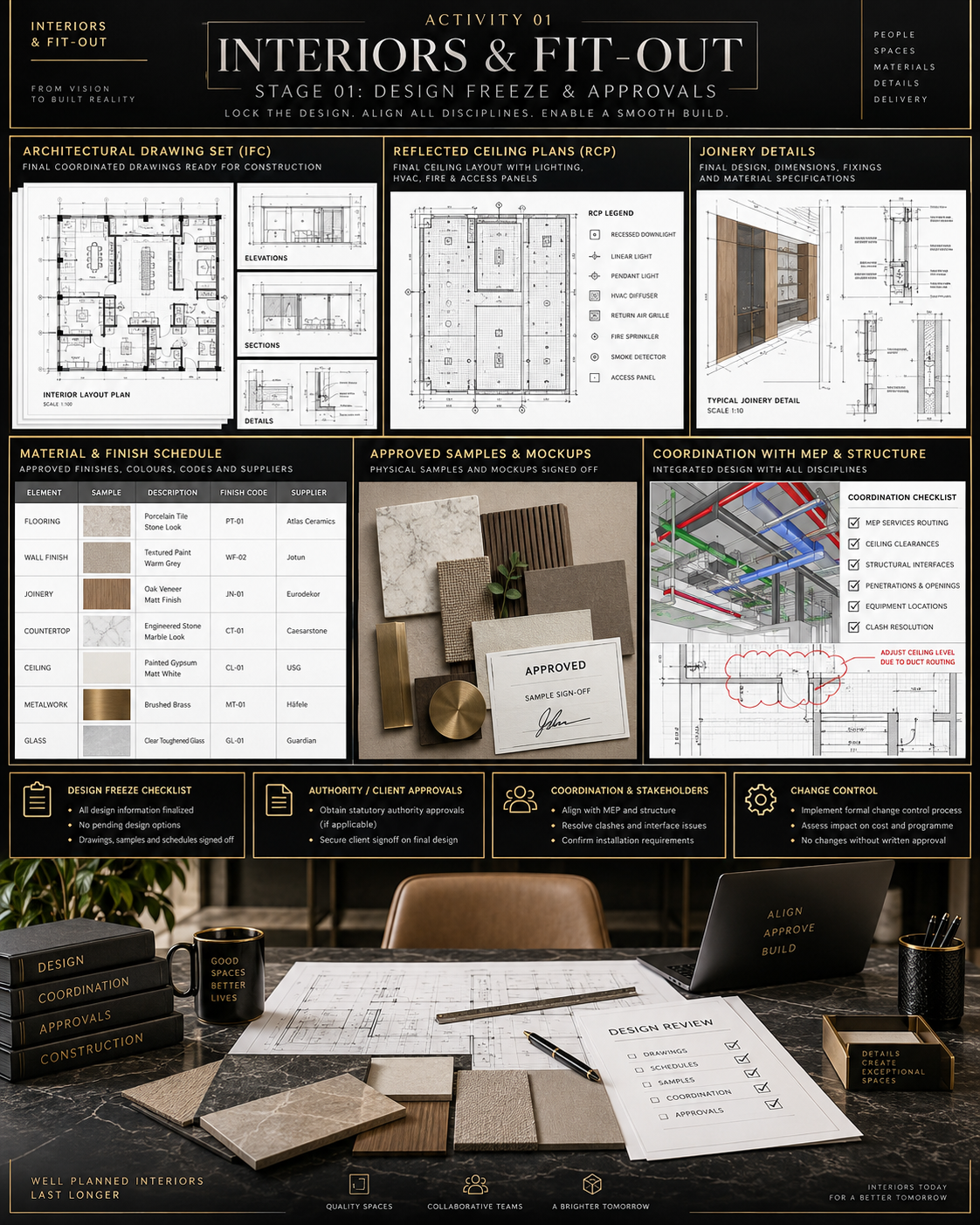

Design Freeze

Confirm scope, authority/landlord requirements, approved drawings, samples and work zones

Engineering intent

Select standard, moisture-resistant, fire-rated or acoustic boards to suit the location and tested assembly

Inspection / hold point

Latest approved drawings are available at the workface

Best practice

Freeze coordinated drawings before ordering bespoke materials

Failure to avoid

Starting construction on uncoordinated drawings

Handover / maintenance

Clean finishes with manufacturer-approved products and avoid abrasive chemicals on sensitive surfaces

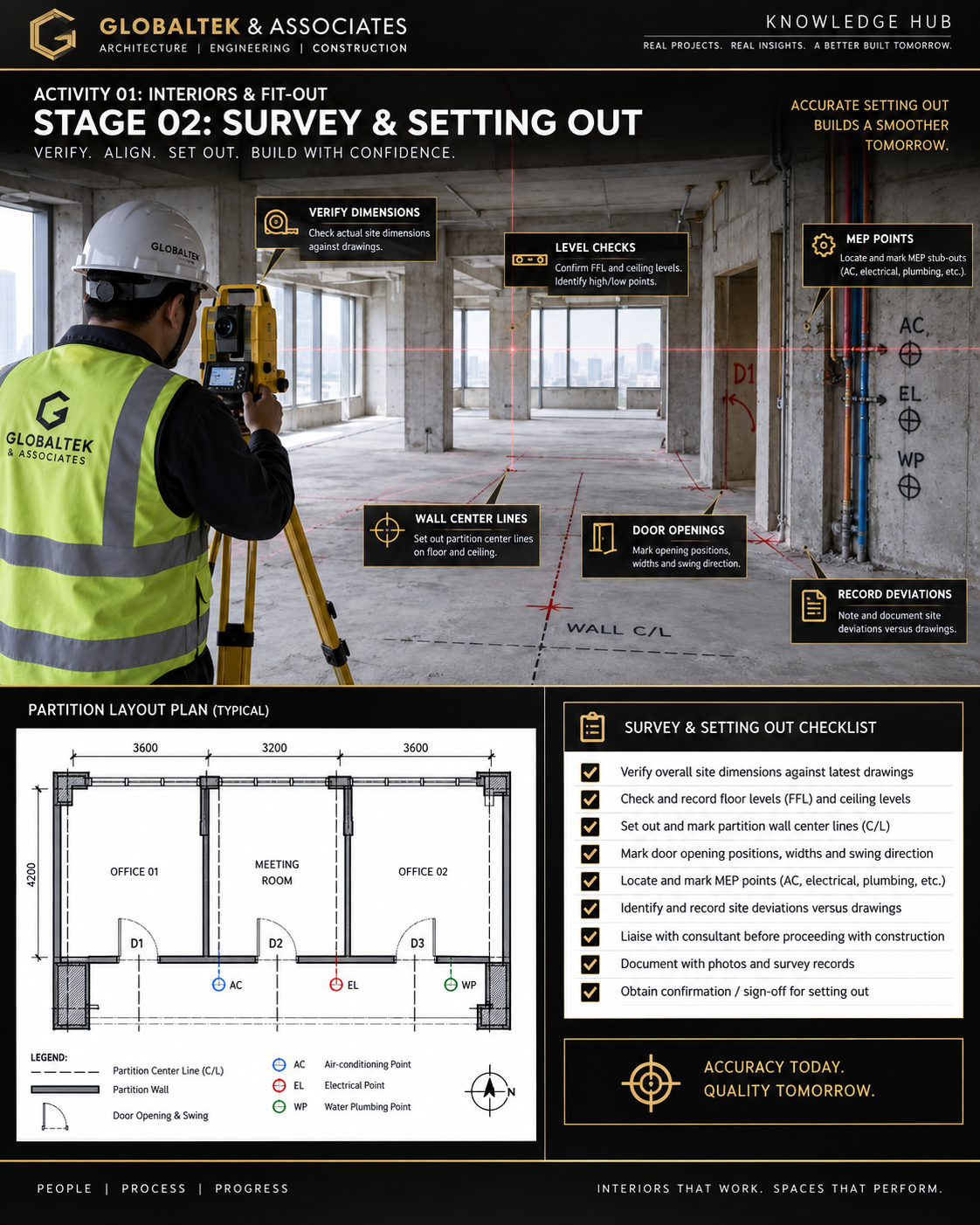

Survey Setting Out technical drawing
STAGE 02

Survey Setting Out

Verify dimensions, levels, existing services, structural restrictions and access before fabrication

Engineering intent

Gauge, spacing and bracing to the approved system and height/load requirement

Inspection / hold point

Materials match approved submittals and samples

Best practice

Use approved samples and mock-ups for visible or high-value finishes

Failure to avoid

Closing ceilings or walls before inspection of concealed services

Handover / maintenance

Inspect sealants, wet-area joints, expansion joints and high-use hardware periodically

First Fix technical drawing
STAGE 03

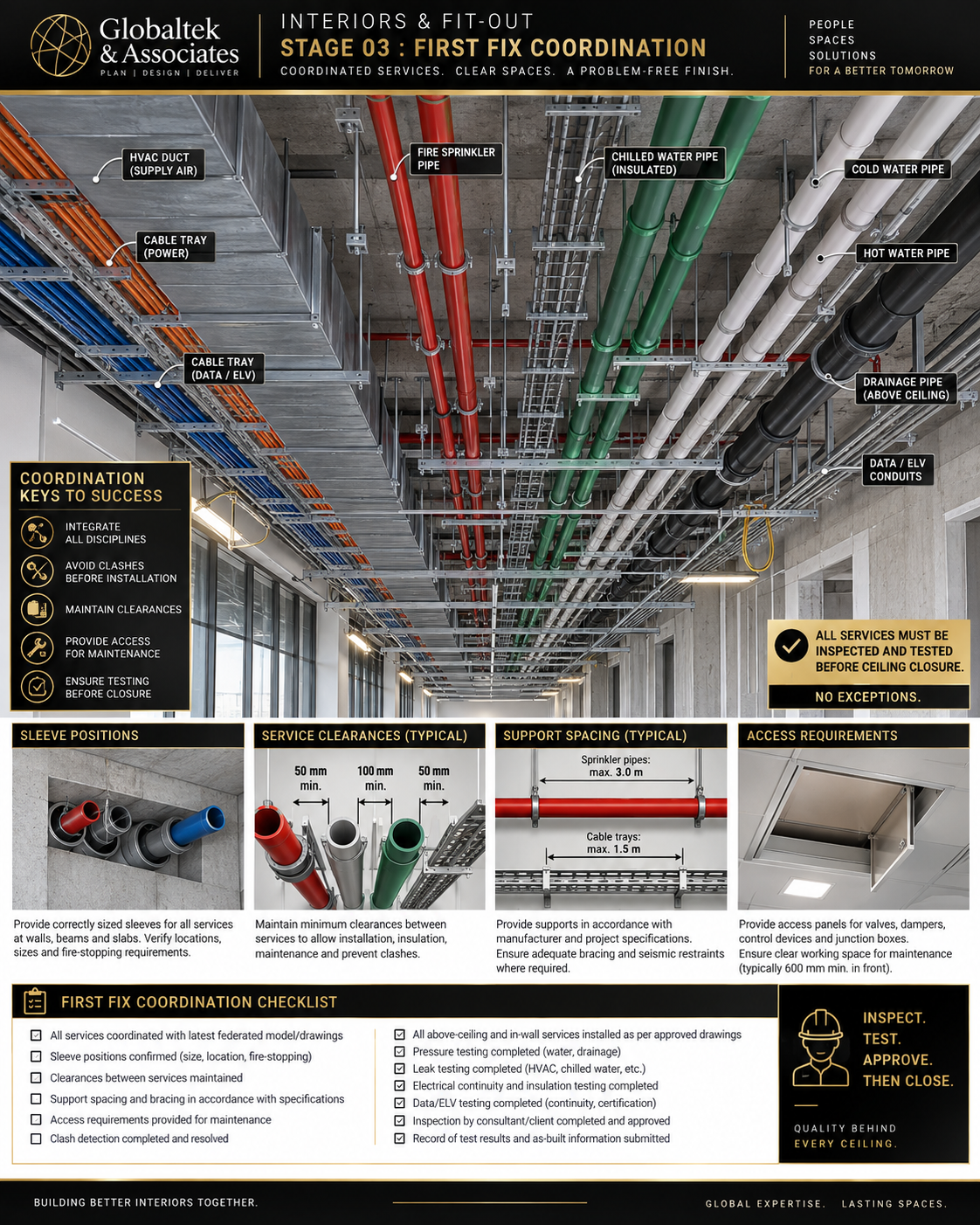

First Fix

Coordinate MEP containment, sleeves, supports, backing, access panels and penetrations before closure

Engineering intent

Hanger spacing, perimeter trims and access provisions to approved system details

Inspection / hold point

Concealed work is inspected before closure

Best practice

Plan access panels and maintenance zones before ceiling closure

Failure to avoid

Selecting finishes by appearance without checking fire, moisture or maintenance performance

Handover / maintenance

Keep access panels and service zones unobstructed

Partitions Wetworks technical drawing
STAGE 04

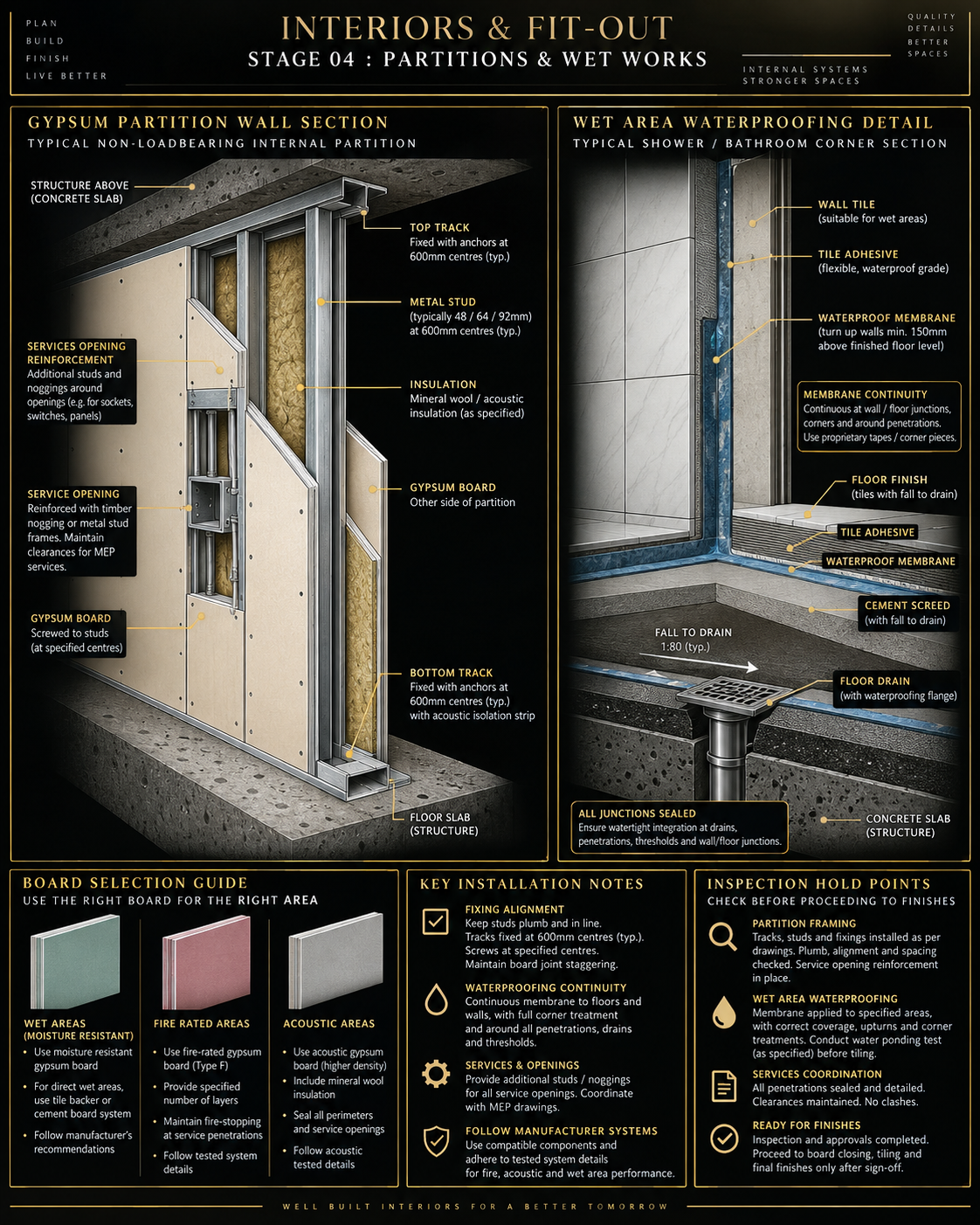

Partitions Wetworks

Build tested assemblies in the correct sequence and inspect concealed elements before boarding or closing

Engineering intent

Mock-ups / control samples should establish colour, sheen, texture and workmanship benchmark

Inspection / hold point

Dimensions, levels, alignment, joints and interfaces are checked before final fixing

Best practice

Protect stone, joinery, glass and finished flooring from following trades

Failure to avoid

Ignoring access to valves, FCUs, cleanouts and control equipment

Handover / maintenance

Repair water leaks quickly to prevent hidden damage to boards, insulation and joinery

Finishes Second Fix technical drawing
STAGE 05

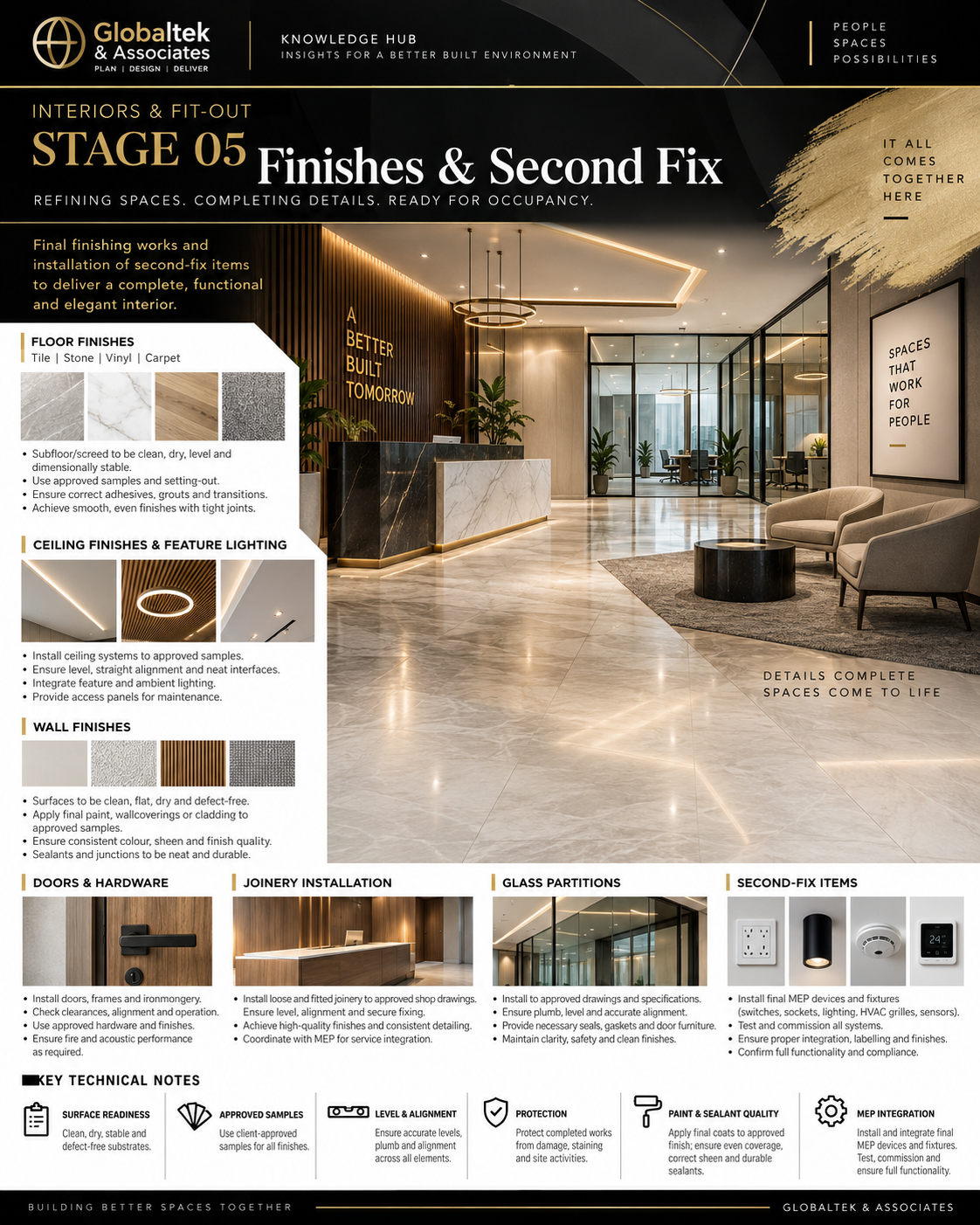

Finishes Second Fix

Complete flooring, painting, joinery, fixtures, grilles, switches and architectural detailing after substrates are accepted

Engineering intent

Levels, plumb, alignment, joint quality and interfaces should comply with specification and accepted workmanship standards

Inspection / hold point

Fire and acoustic penetrations are treated with compatible approved systems

Best practice

Sequence dusty and wet trades before sensitive final finishes

Failure to avoid

Allowing finished work to remain unprotected during subsequent trades

Handover / maintenance

Retain approved finish codes and spare materials for future touch-up / replacement

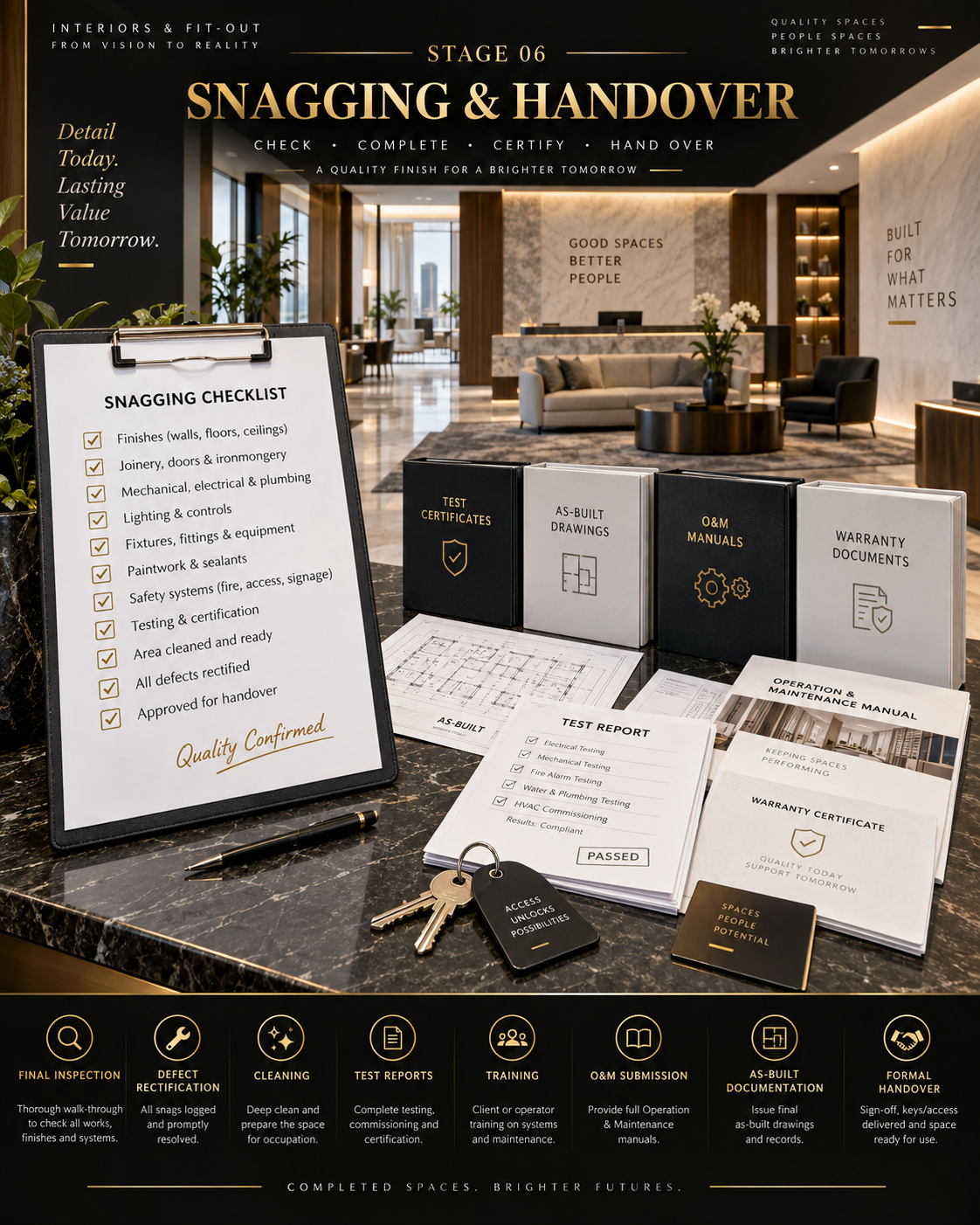

Snag Handover technical drawing
STAGE 06

Snag Handover

Test services, rectify defects, protect finishes and submit as-builts, warranties and maintenance information

Engineering intent

Use suitable waterproofing, sealants, moisture-resistant substrates and tested penetrations

Inspection / hold point

Final finishes are protected, snagged, cleaned and documented at handover

Best practice

Maintain daily interface reviews between architectural, MEP and specialist subcontractors

Failure to avoid

Leaving handover records and O&M documents until the final week

Handover / maintenance

Maintain an asset list for lights, controls, HVAC terminals, sanitary fittings and specialist equipment

04 · TECHNICAL CHAPTERS

9 detailed sub-activities for Interiors & Fit-out Works.

The file naming and page mapping are one-to-one: each technical subject has its own individual high-resolution image.

Partitions
TECHNICAL CHAPTER 01

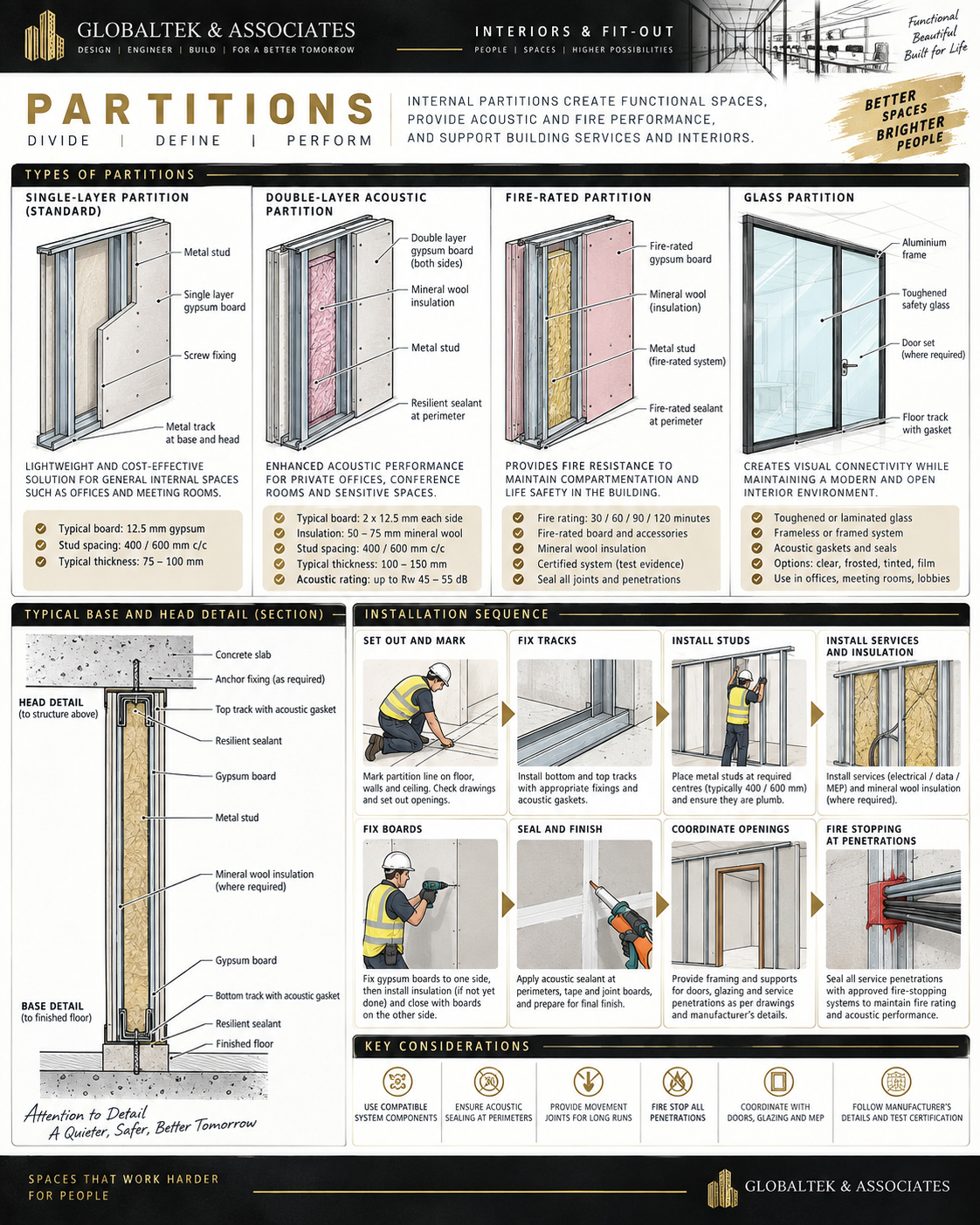

Partitions

Partitions: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for partitions before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Latest approved drawings are available at the workface

Failure to avoid

Starting construction on uncoordinated drawings

Maintenance / long-term performance

Clean finishes with manufacturer-approved products and avoid abrasive chemicals on sensitive surfaces

Ceilings
TECHNICAL CHAPTER 02

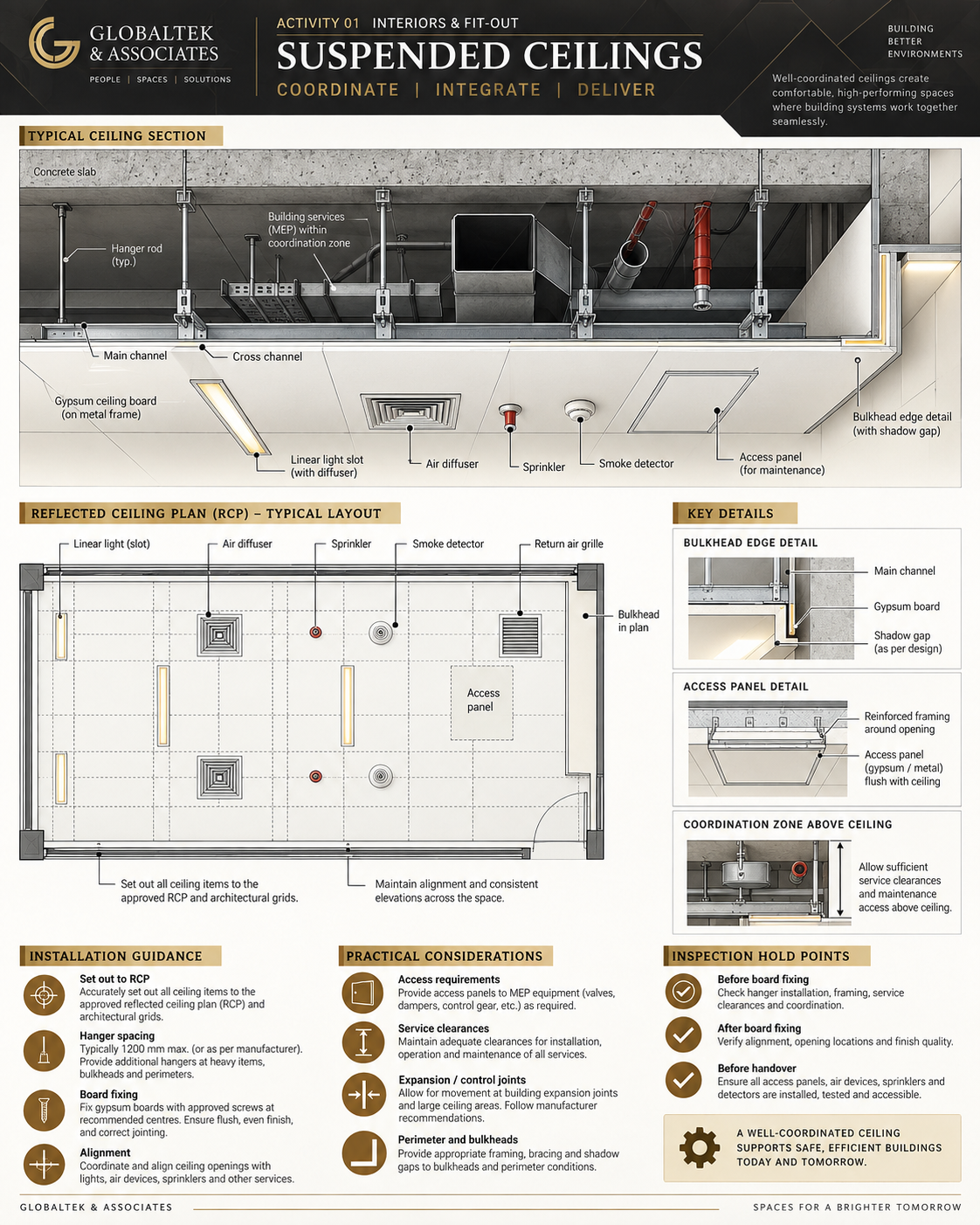

Ceilings

Ceilings: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for ceilings before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Materials match approved submittals and samples

Failure to avoid

Closing ceilings or walls before inspection of concealed services

Maintenance / long-term performance

Inspect sealants, wet-area joints, expansion joints and high-use hardware periodically

Flooring
TECHNICAL CHAPTER 03

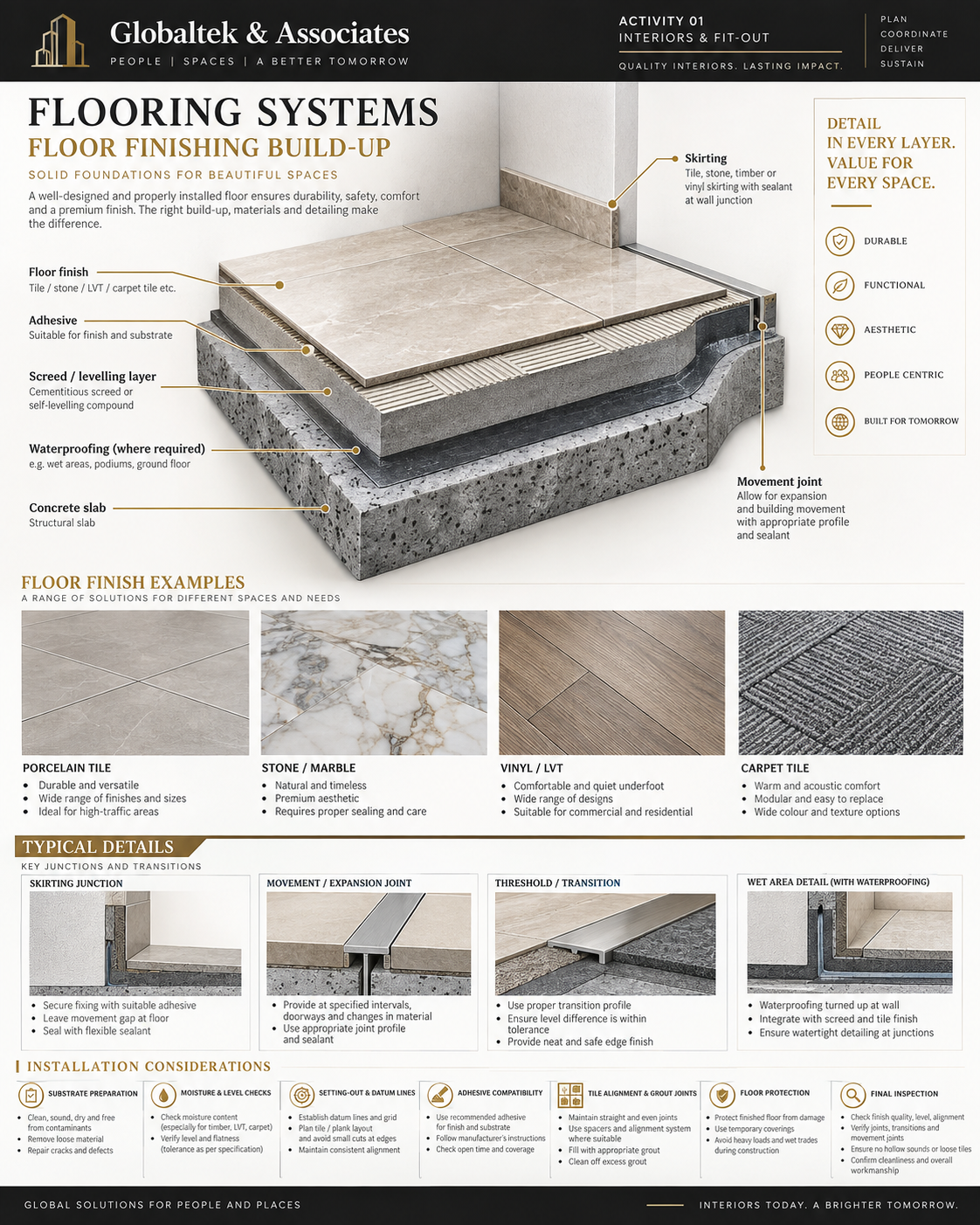

Flooring

Flooring: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for flooring before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Concealed work is inspected before closure

Failure to avoid

Selecting finishes by appearance without checking fire, moisture or maintenance performance

Maintenance / long-term performance

Keep access panels and service zones unobstructed

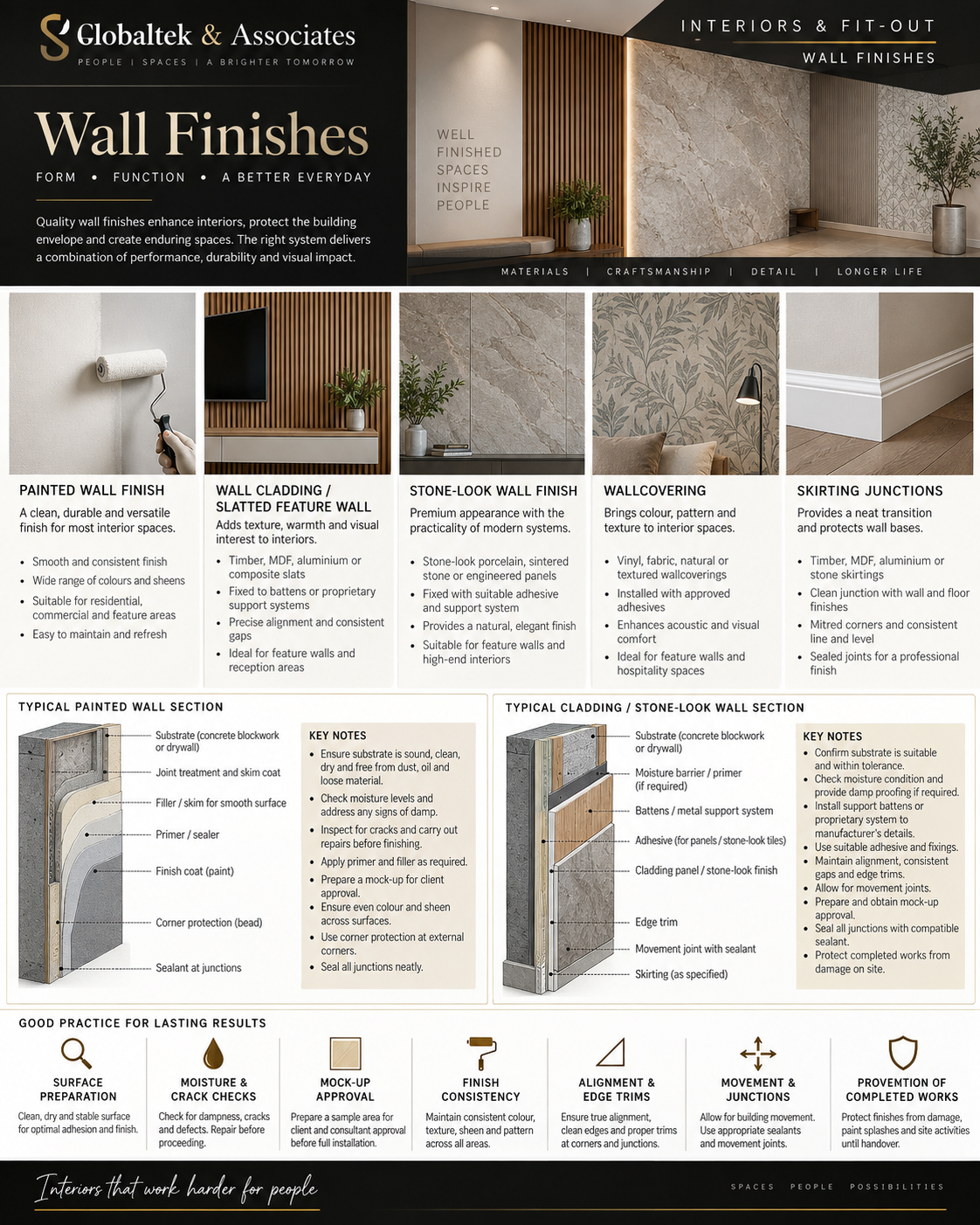

Wall Finishes
TECHNICAL CHAPTER 04

Wall Finishes

Wall Finishes: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for wall finishes before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Dimensions, levels, alignment, joints and interfaces are checked before final fixing

Failure to avoid

Ignoring access to valves, FCUs, cleanouts and control equipment

Maintenance / long-term performance

Repair water leaks quickly to prevent hidden damage to boards, insulation and joinery

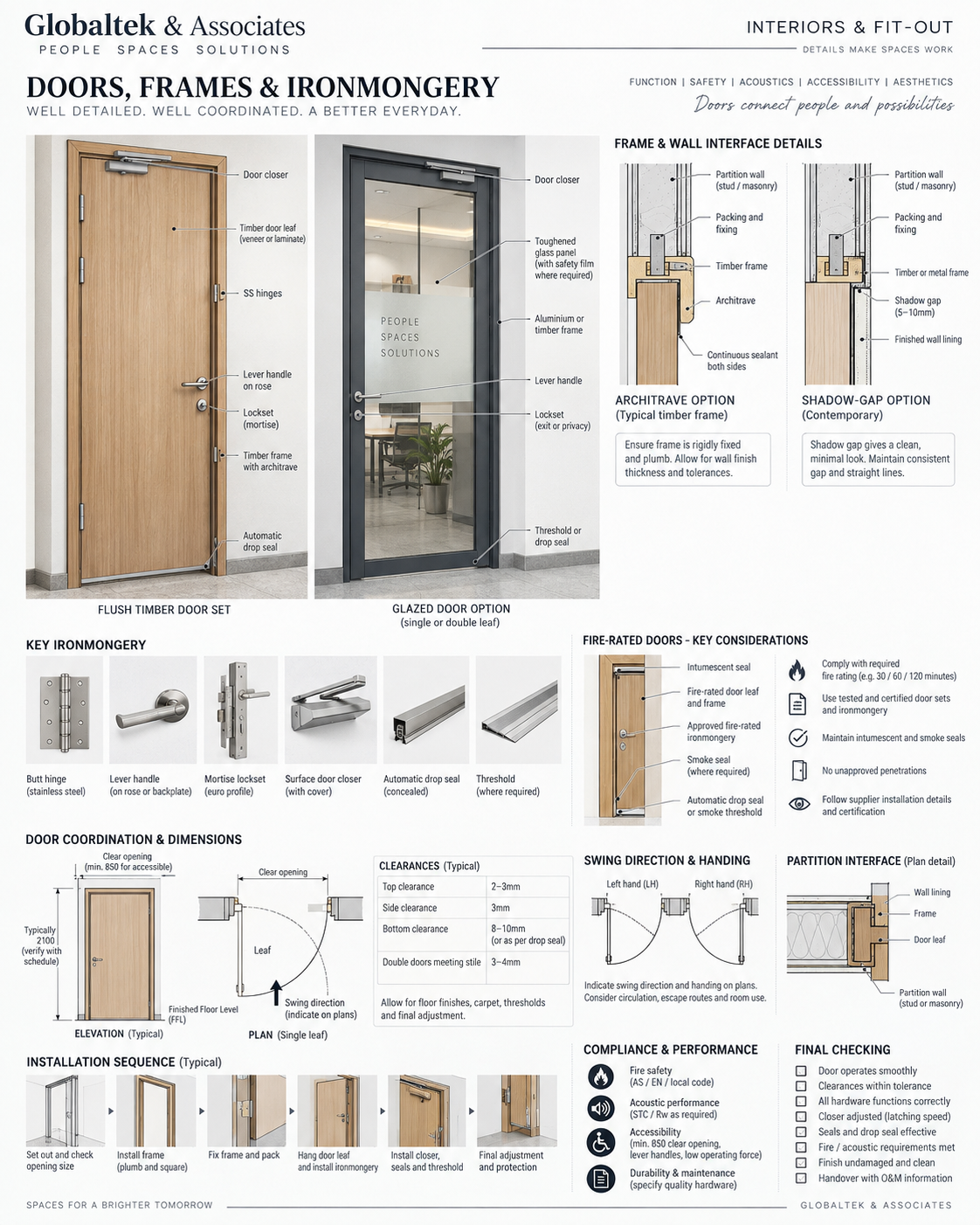

Doors Frames Ironmongery
TECHNICAL CHAPTER 05

Doors Frames Ironmongery

Doors Frames Ironmongery: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for doors frames ironmongery before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Fire and acoustic penetrations are treated with compatible approved systems

Failure to avoid

Allowing finished work to remain unprotected during subsequent trades

Maintenance / long-term performance

Retain approved finish codes and spare materials for future touch-up / replacement

Glass Partitions
TECHNICAL CHAPTER 06

Glass Partitions

Glass Partitions: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for glass partitions before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Final finishes are protected, snagged, cleaned and documented at handover

Failure to avoid

Leaving handover records and O&M documents until the final week

Maintenance / long-term performance

Maintain an asset list for lights, controls, HVAC terminals, sanitary fittings and specialist equipment

Wet Area Waterproofing
TECHNICAL CHAPTER 07

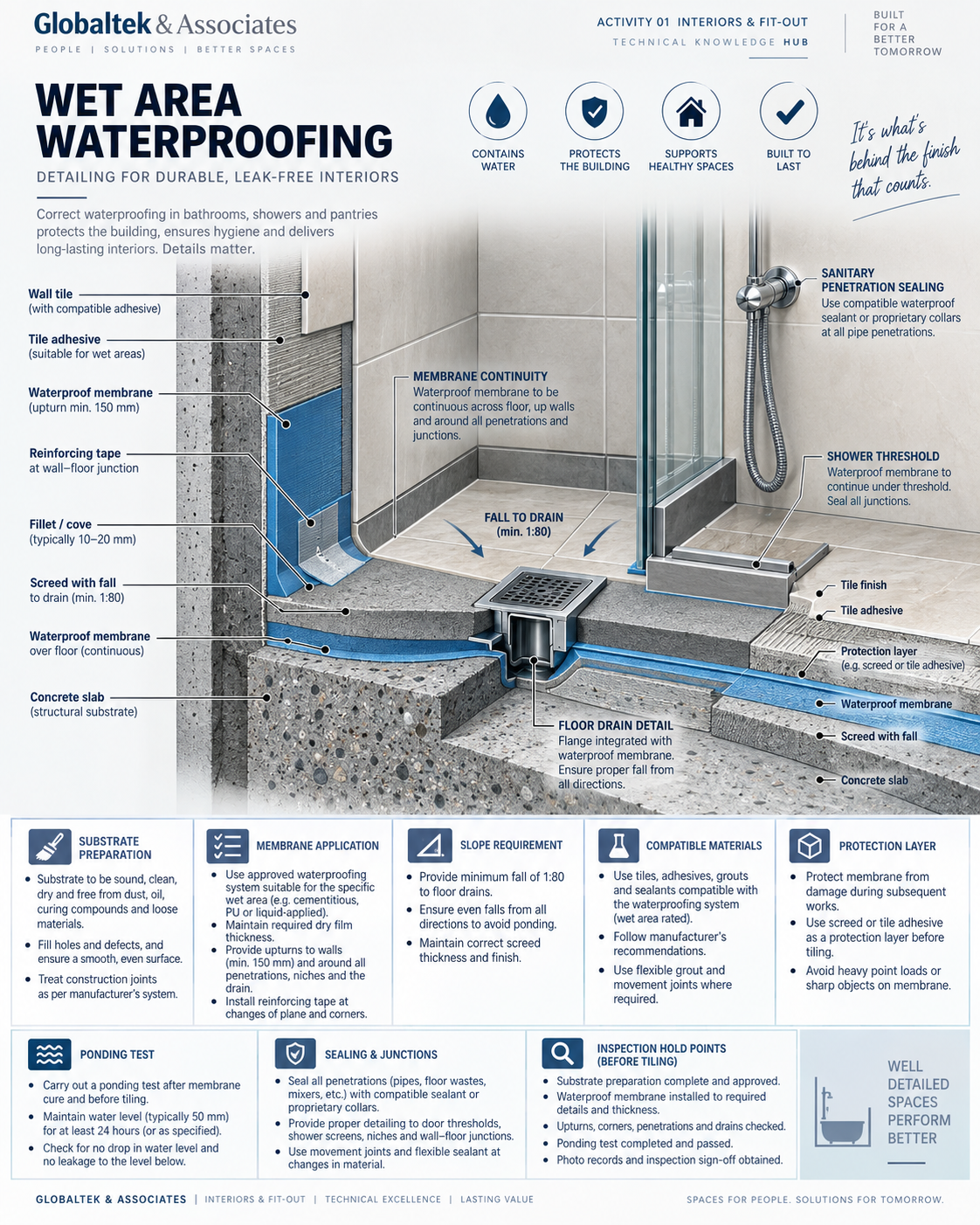

Wet Area Waterproofing

Wet Area Waterproofing: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for wet area waterproofing before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Latest approved drawings are available at the workface

Failure to avoid

Starting construction on uncoordinated drawings

Maintenance / long-term performance

Clean finishes with manufacturer-approved products and avoid abrasive chemicals on sensitive surfaces

Joinery Coordination
TECHNICAL CHAPTER 08

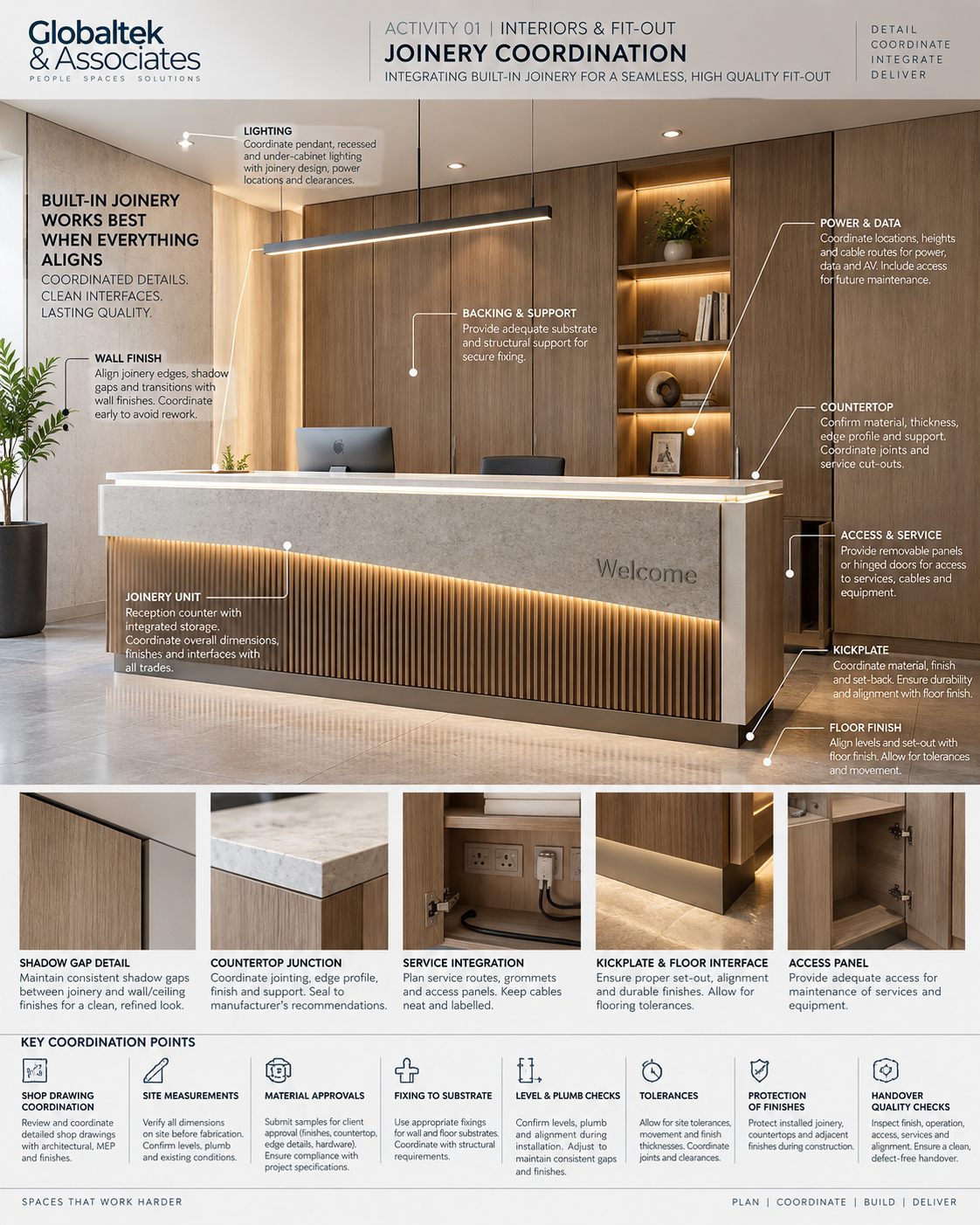

Joinery Coordination

Joinery Coordination: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for joinery coordination before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Materials match approved submittals and samples

Failure to avoid

Closing ceilings or walls before inspection of concealed services

Maintenance / long-term performance

Inspect sealants, wet-area joints, expansion joints and high-use hardware periodically

Lighting Integration
TECHNICAL CHAPTER 09

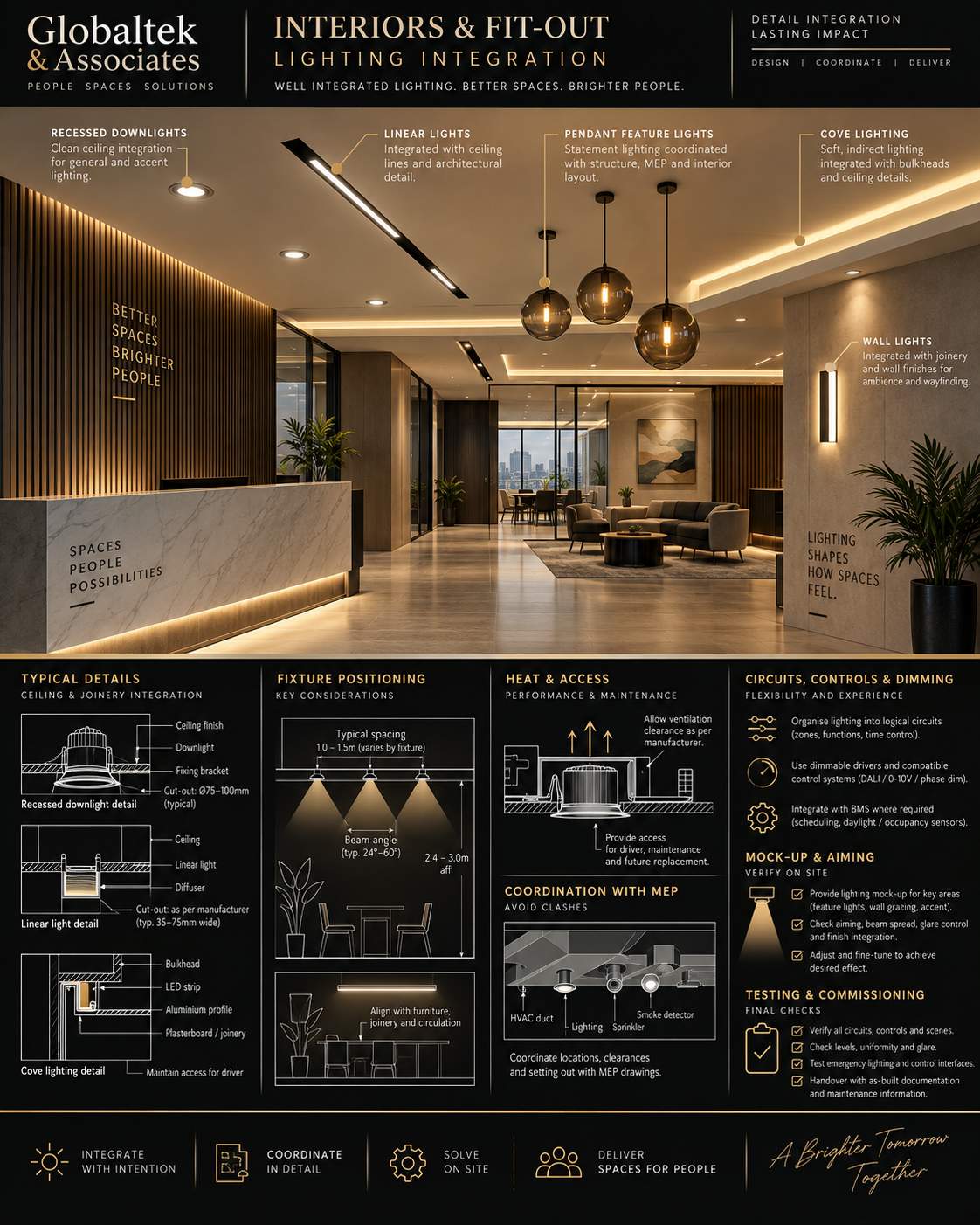

Lighting Integration

Lighting Integration: Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Design intent

Define the performance and construction intent for lighting integration before fabrication or installation. Read the drawing together with the approved project specification, manufacturer data and adjoining details.

Coordination

Coordinate substrates, room geometry, MEP interfaces, access, fire/acoustic requirements, tolerances, finishes and protection in the correct top-down execution sequence.

Inspection / QA

Concealed work is inspected before closure

Failure to avoid

Selecting finishes by appearance without checking fire, moisture or maintenance performance

Maintenance / long-term performance

Keep access panels and service zones unobstructed

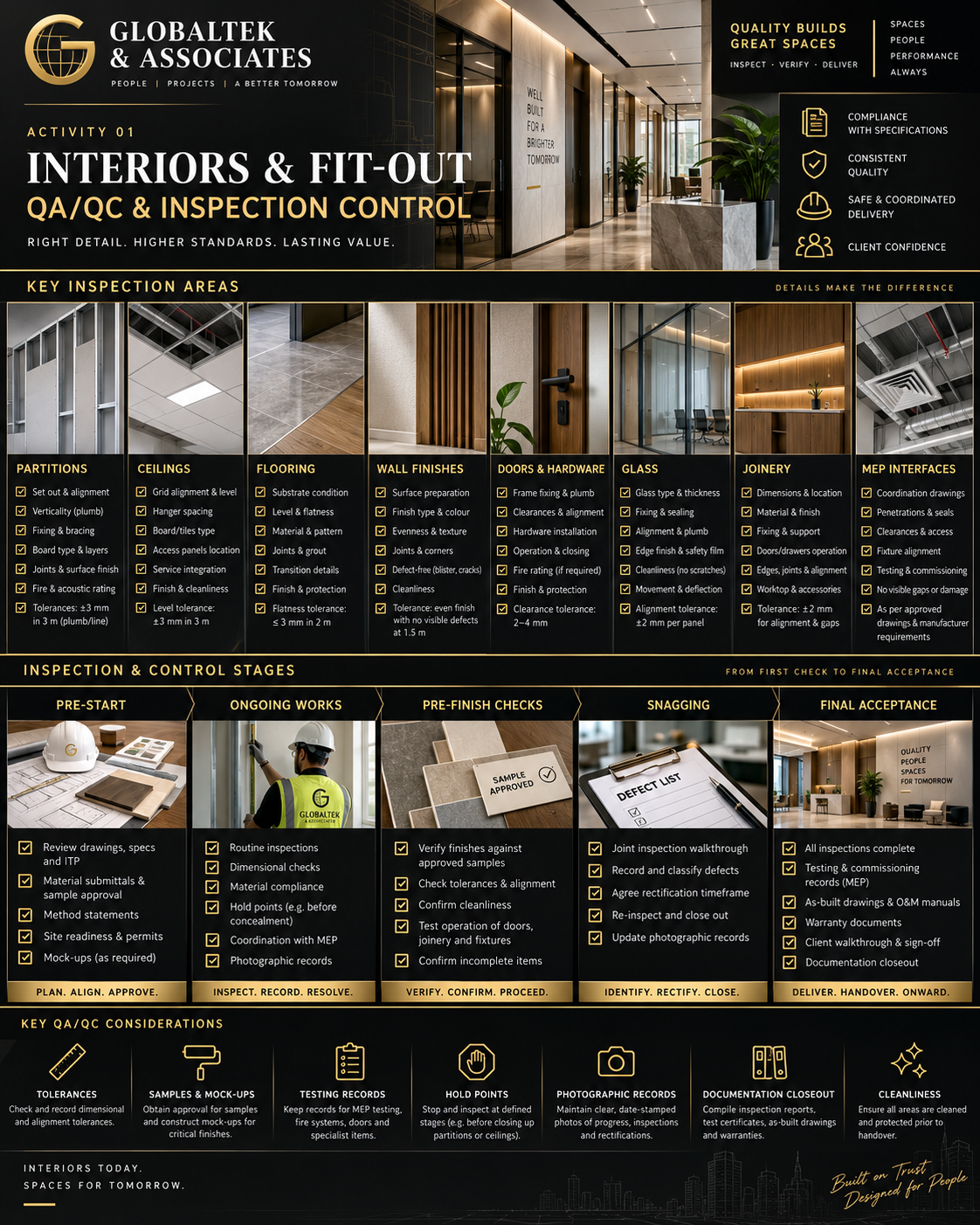

05 · QA/QC

Inspect before concealment and before handover.

Interiors & Fit-out Works QA QC
01Latest approved drawings are available at the workface
02Materials match approved submittals and samples
03Concealed work is inspected before closure
04Dimensions, levels, alignment, joints and interfaces are checked before final fixing
05Fire and acoustic penetrations are treated with compatible approved systems
06Final finishes are protected, snagged, cleaned and documented at handover

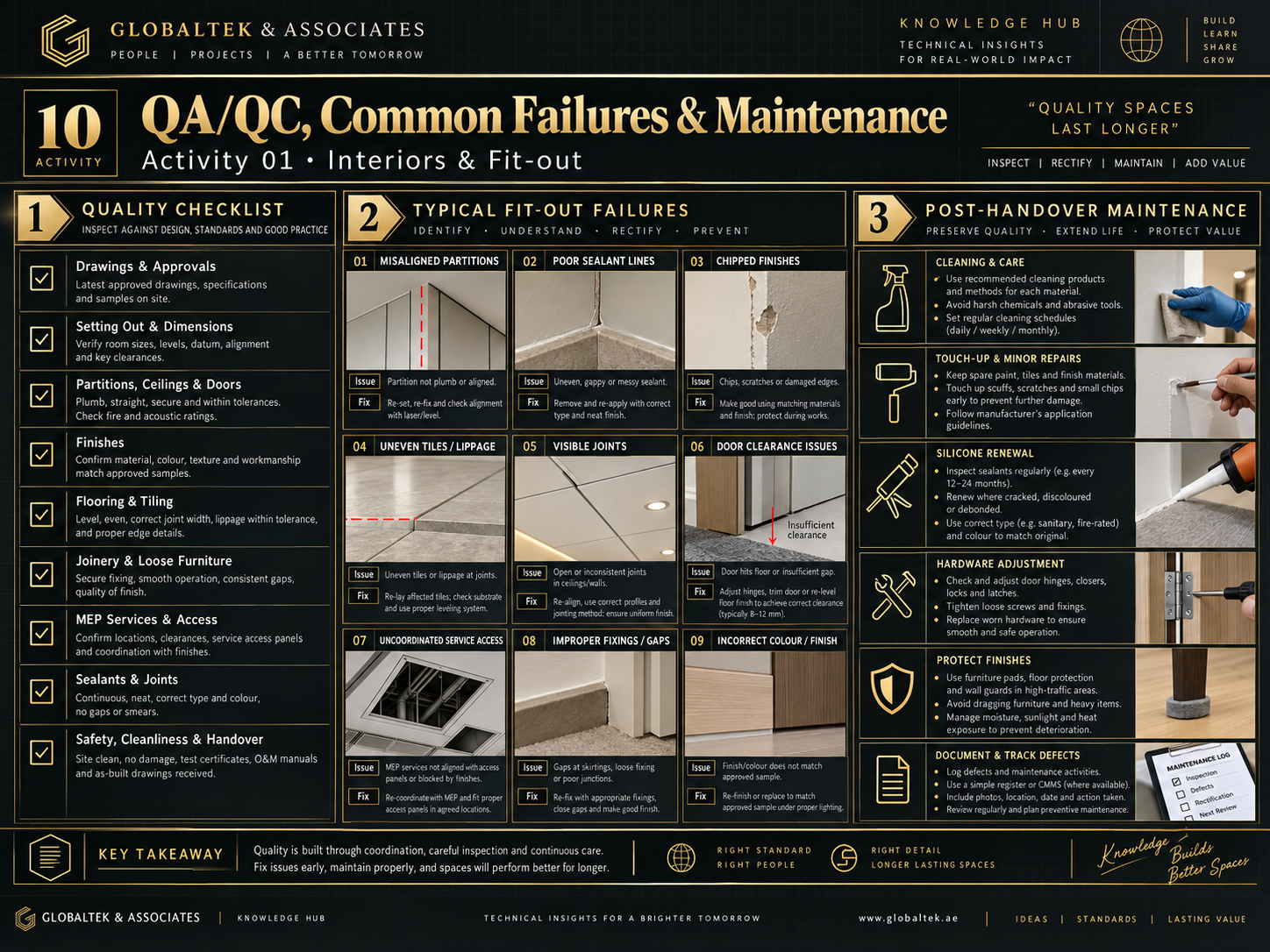

06 · COMMON FAILURES

Recognise the failure mechanism—not only the visible defect.

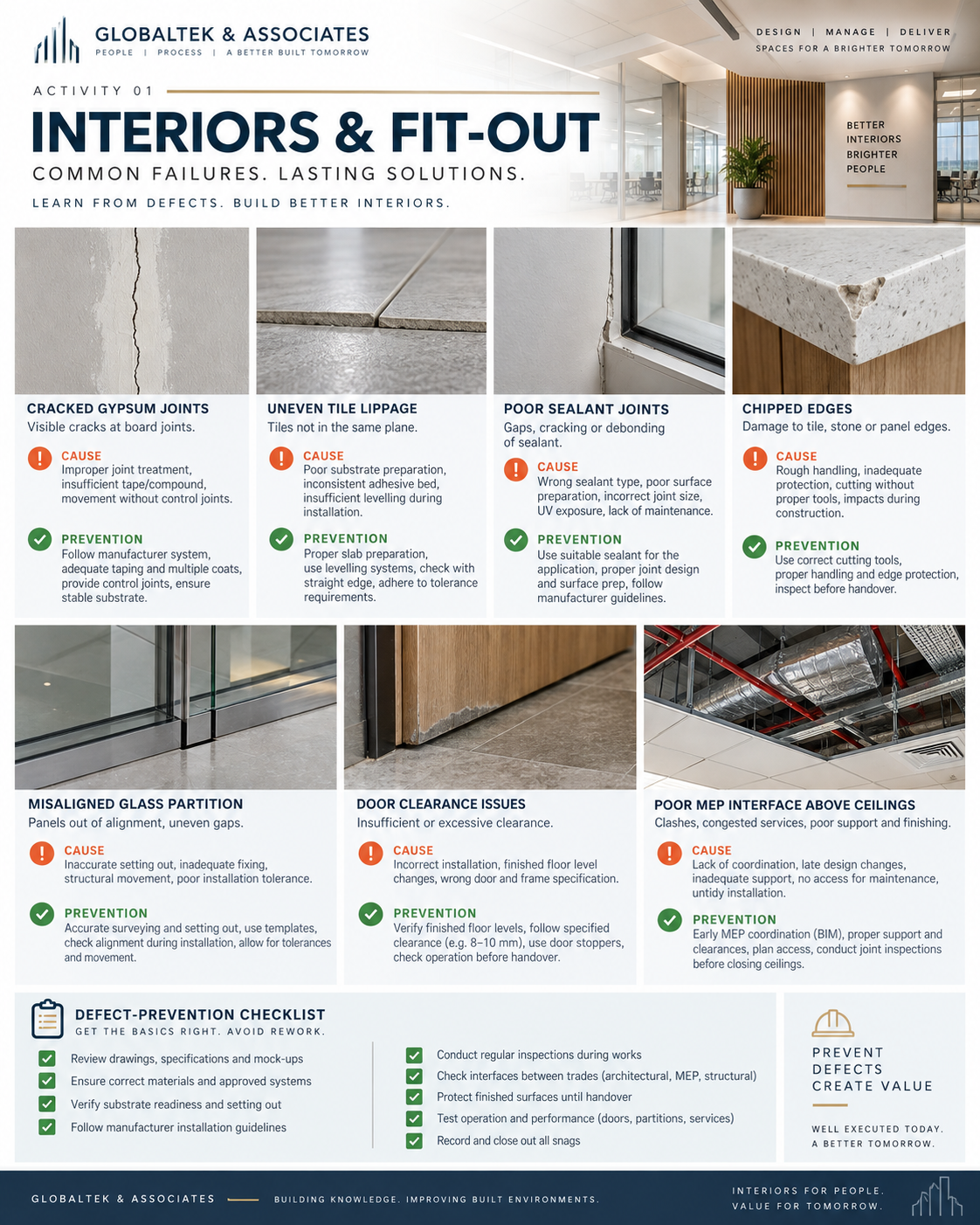

Failures to avoid

×Starting construction on uncoordinated drawings

×Closing ceilings or walls before inspection of concealed services

×Selecting finishes by appearance without checking fire, moisture or maintenance performance

×Ignoring access to valves, FCUs, cleanouts and control equipment

×Allowing finished work to remain unprotected during subsequent trades

×Leaving handover records and O&M documents until the final week

Interiors & Fit-out Works common failures
07 · MAINTENANCE & AFTERCARE

Design for access, repair and long-term performance.

Interiors & Fit-out Works maintenance

Maintenance controls

✓Clean finishes with manufacturer-approved products and avoid abrasive chemicals on sensitive surfaces

✓Inspect sealants, wet-area joints, expansion joints and high-use hardware periodically

✓Keep access panels and service zones unobstructed

✓Repair water leaks quickly to prevent hidden damage to boards, insulation and joinery

✓Retain approved finish codes and spare materials for future touch-up / replacement

✓Maintain an asset list for lights, controls, HVAC terminals, sanitary fittings and specialist equipment

08 · STANDARDS & MANUFACTURER REFERENCES

Use the latest approved project documents and tested systems.

• UAE Fire and Life Safety Code and current Civil Defence requirements where applicable

• Landlord / developer fit-out manual, NOCs and permit conditions

• Approved architectural, MEP, fire-life-safety and reflected ceiling drawings

• ASTM / EN / BS product standards referenced by the project specification

• Manufacturer installation instructions and tested system details

• Approved method statements, inspection test plans, material submittals and samples

Interiors & Fit-out Works standards and brands
Technical guidance is educational and indicative. Final design, dimensions, materials, installation details and acceptance criteria must follow the approved project documents, manufacturer instructions and the latest requirements of the relevant UAE authority, landlord, consultant and specialist engineer.
09 · COMPLETE IMAGE LIBRARY

22 high-resolution visuals assigned to this activity.

Each file remains separate and is mapped directly to its relevant section. Click any image to inspect it at full resolution.

WA
